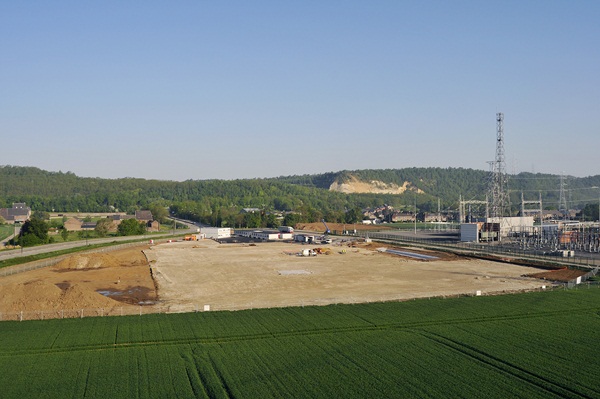

In February, we told you that the first stage of the converter station project would last until April. This soil reinforcement stage went well. The 5,200 ballasted columns have now been injected and the stage is complete.

Construction of the building can now begin. This civil engineering stage will take about a year and will be similar to any other building construction project. It will be followed by the installation of electrical equipment.

Local residents will undoubtedly have noticed the arrival of new containers. These will be used by the administrative and technical teams – who are responsible for the smooth running of the project – to coordinate the teams and monitor the progress of the works from the site itself.

You can also monitor the progress of the project on our dynamic map.

Deze website gebruikt cookies voor een optimale browserervaring. Sommige cookies zijn strikt noodzakelijk voor de werking van deze website en kunnen niet worden geweigerd; andere hebben analytische/functionele/targetingdoeleinden en kunnen worden geweigerd, behalve de cookies van analyse van het verkeer. Raadpleeg onsCookiebeleid voor meer informatie. U kunt uw cookievoorkeuren op elk ogenblik beheren/aanpassen. Als u uw cookievoorkeuren niet beheert, zullen alleen de strikt noodzakelijke cookies worden aanvaard.
